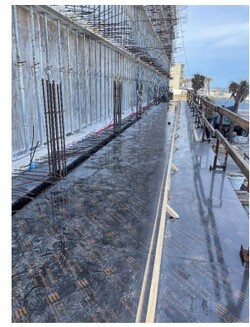

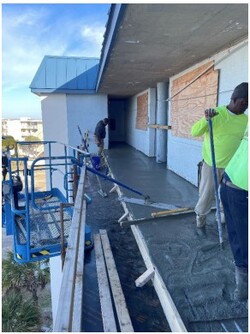

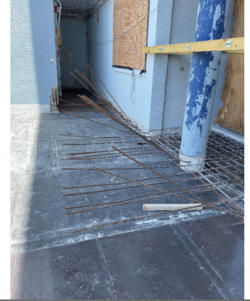

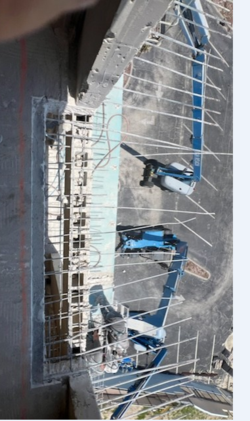

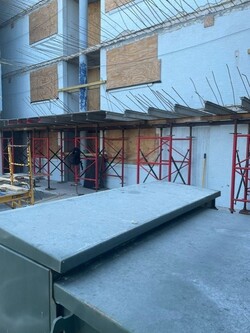

: Decking installed for the construction of the 2nd floor balcony slab

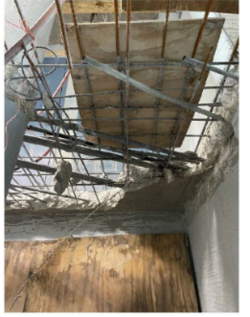

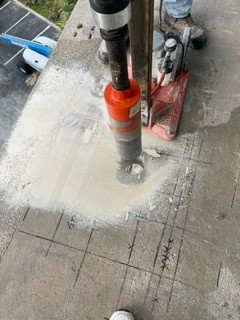

Typical dowels drilled for the 2nd floor balcony slab

12/06/24

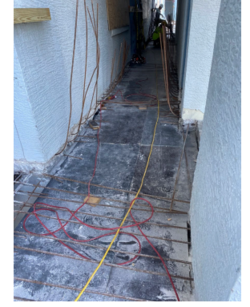

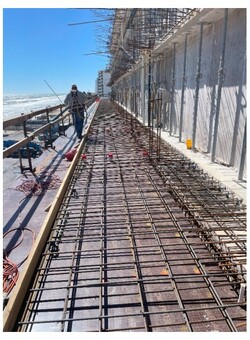

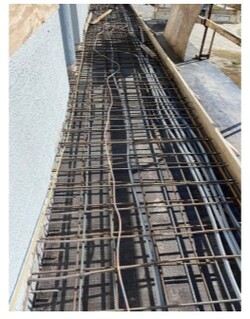

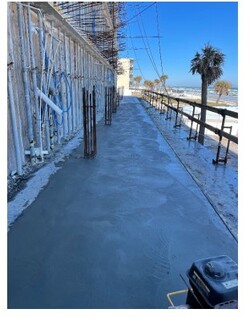

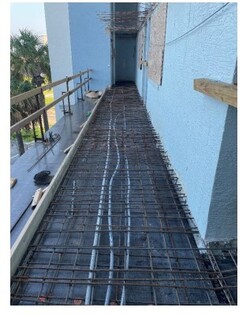

Casting 5th floor walkway slab in-progress
12-05-24

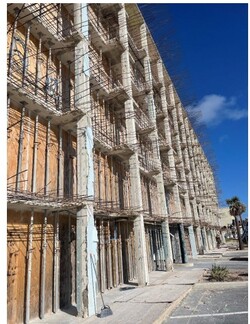

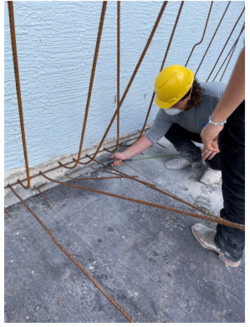

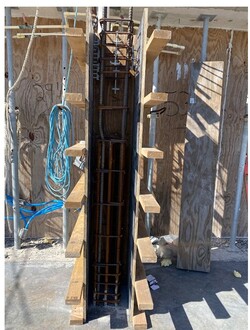

Typical steel installation

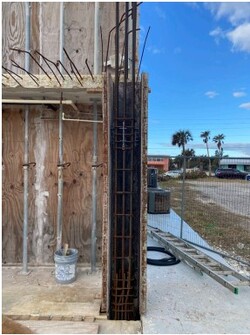

In-progress column forming
12/03/24

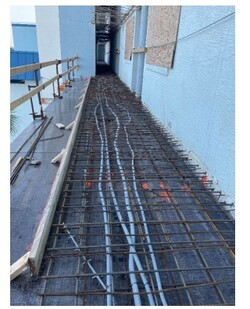

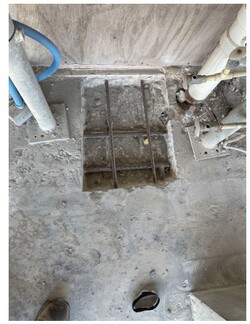

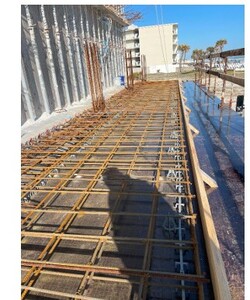

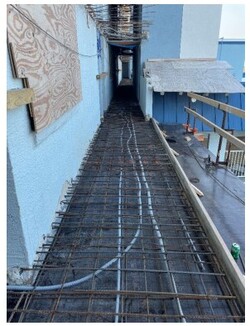

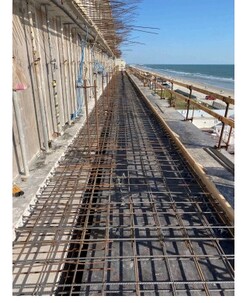

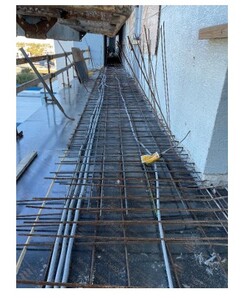

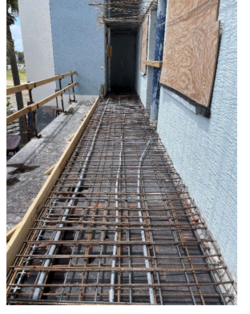

: Typical doweling on 5th floor walkway

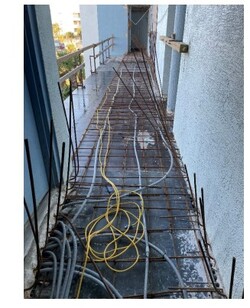

In-progress steel installation for the 5th floor walkway slab

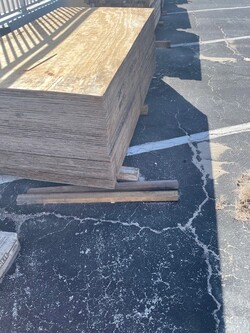

Form board installation for the 1st floor beam
11-25-24
Typical doweling on 5th floor walkway
In-progress beam steel installation
11-22-24

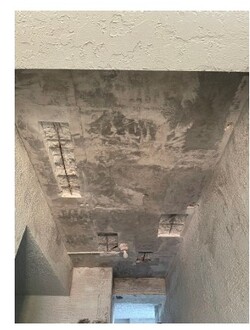

Typical dowels completed for the 5th floor slab
Typical dowels completed for the 5th floor slab
11-21-24

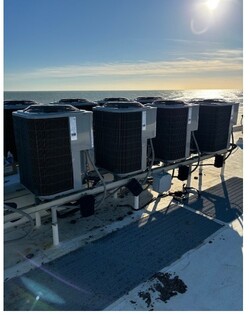

A C Units installed
11/20/24

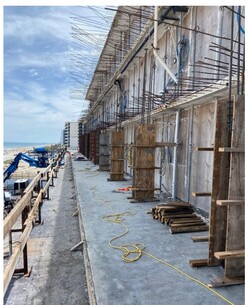

Typical column steel installation
North set of columns approved to be cast
In-progress shoring installation
11/19/24
Support columns on south side
North side framing commenced
11/14/24

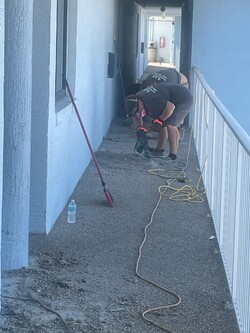

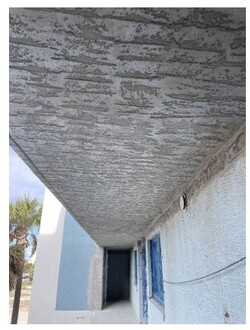

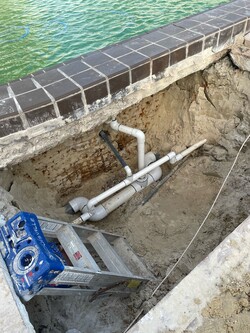

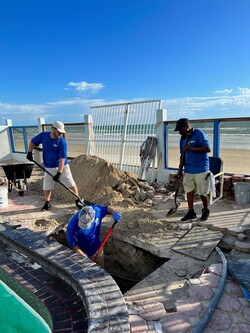

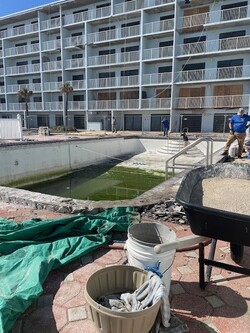

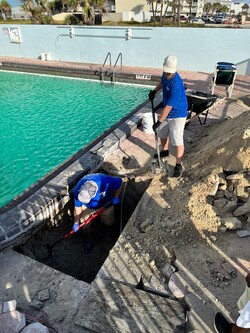

Typical repairs in the pool breezeway
Typical repairs in the drive through lane
Typical repairs in the drive through lane
11/08/24

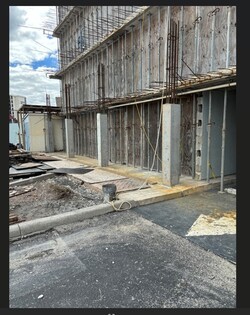

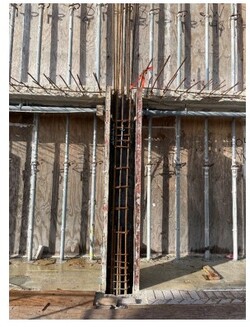

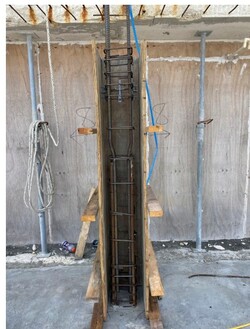

Typical first floor column
Typical first floor column
11/01/24

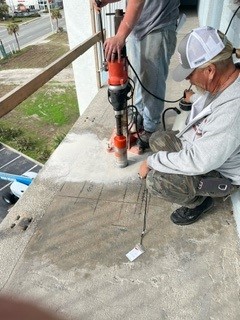

Dowels drilled for the walkway slab steel installation
Dowels drilled for the column steel installation
10-28-24

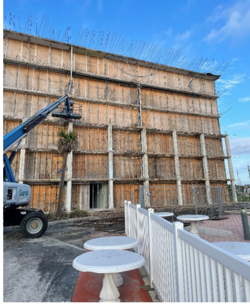

Remaining columns to be removed at the North end of the building
10-18-24
In-progress casting 4th floor walkway slab
In-progress casting 4th floor walkway slab
In-progress casting 4th floor walkway slab

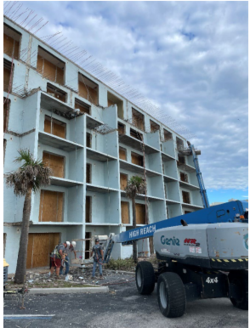

In-progress column removal on the balcony elevation
10-15-24
Typical dowels drilled at the 4th floor walkway

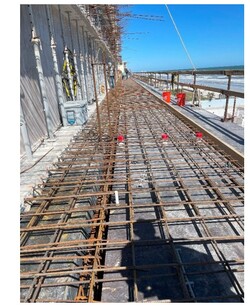

Bottom mat of steel installed at the 4th floor walkway
In-progress debris cleanup at the 3rd floor
In-progress column removal at the 1st floor
10-06-24
10-4-24

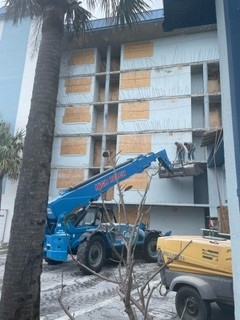

In-progress slab demolition on the North end of the building
In-progress column demolition on the South end of the building
Sunrise 9/28/24
Sunrise
9-26-24
Typical dowels drilled for the 4th floor walkway slab
: Typical dowels drilled for the 4th floor walkway slab
Steel installation for the bottom mat of steel
9-22-24
Typical dowells drilled for the 4th floor walkway slab

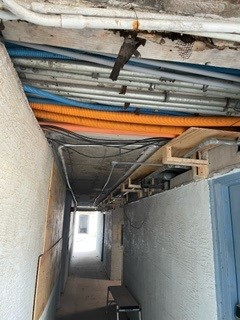

Steel and form board installation within the unit entry door corridor
: In-progress demo on the balcony side of the building
In-progress column demo on the balcony side of the building
9/13/24
9/04/24
Typical completed dowels for the 4th floor slab
Typical completed dowels for the 4th floor slab
8-30-24
In-progress demolition on the balcony side of the building

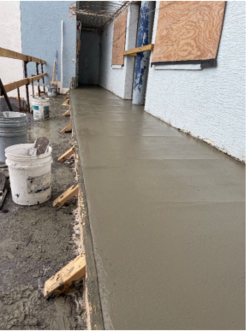

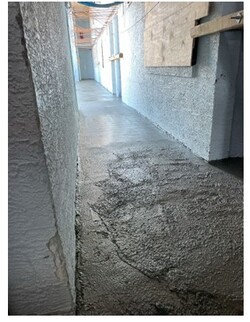

Interior termination point for slab
In-progress demolition on the balcony side of the building
8-21-24
In-progress demolition on the South half of the building
8-13-24

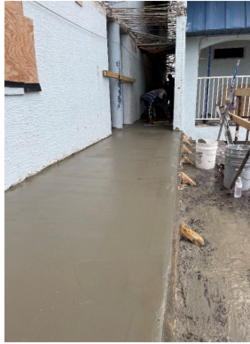

: In-progress concrete placement
8-8-24

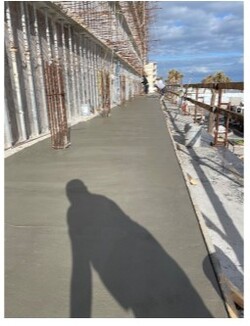

3rd floor walkway slab construction
3rd floor walkway slab construction
3rd floor walkway slab construction

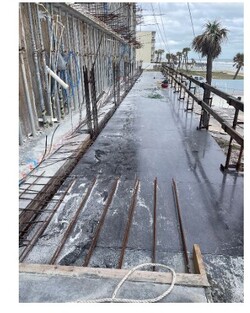

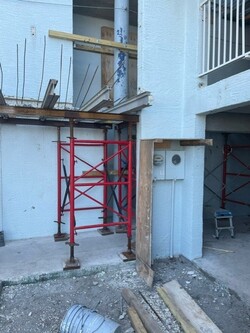

Post shore installation on the balcony side of building

8/1/24
Completed dowels 3rd floor slab
End wall removed on balcony side of the building
End wall removed on balcony side of the building
7/29/24
Dowels drilled for 3rd floor slab
Dowels drilled for 3rd floor slab
7/26/24
Dowels Drilled for 3rd floor slab
Dowels drilled for 3rd floor slab
Form board construction
Demo for balcony side of the building

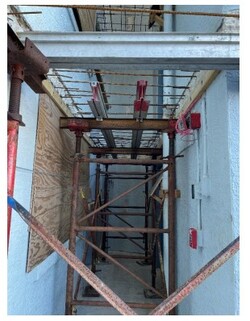

7/25/24
In-progress demolition on the North elevation 2nd floor
Shoring/bracing installation on the South end of the walkways
Shoring/bracing installation on the South end of the walkways
7/18//24
In-progress demolition on the North elevation 4th floor

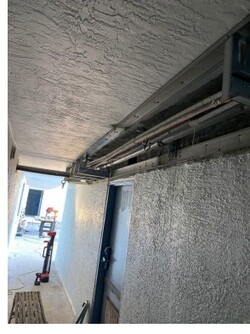

Typical ledger board installation
Typical ledger board installation
7/8/24

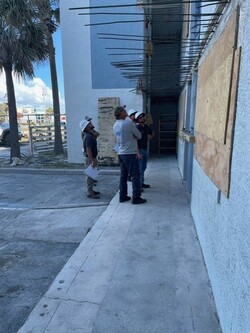

Demo completed at unit entry corridors

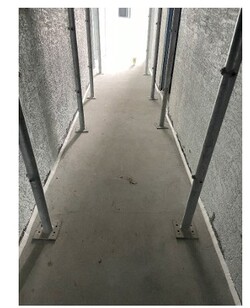

Walkway on the South end of the building
3rd floor existing slab steel cleaned
In-progress demolition on the balcony side of the building
6/26/24
In-progress of cleaning out the forms on the South end of the walkway
In-progress of cleaning out forms on the South end of the walkway
Walkway slab replacement in the elevator corridor
Walkway slap replacement on the North end of the building
Walkway slap replacement on the North end of the building

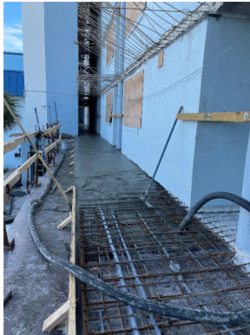

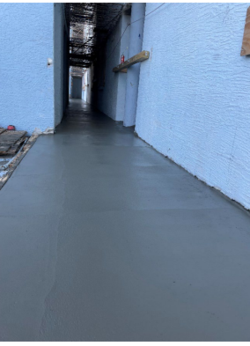

Casting 2nd floor walkway slab
Casting 2nd floor walkway slab
Casting 2nd floor walkway slab
Casting 2nd floor walkway slab
In-progress concrete demo on the balcony side of the building
6/21/24
Dowels completed for the 2nd floor slab
Dowels completed for the 2nd floor slab
Roof slab demo on the balcony side of the building

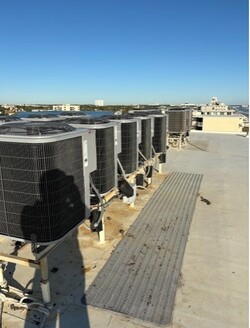

AC Units
40 New AC Units stored between the Lobby and the Gym
6/13/24
Shoring and bottom form boards installed on the South end of the walkway
Typical proper dowel spacing observed
Typical dowels for the bottom mat of steel
In-progress of cleaning out the dowel holes with compressed air
Work in-progress on the balcony side of the building
Work in-progress on the balcony side of the building
6/7/24
2nd floor walkway formwork and in-progress drilling for dowels
In-progress demolition on the balcony elevation
5-29-24
The forms are being established on the first floor. You can see the iron beams, rebar, new rebar, and electrical and plumbing that will go through this floor. It will take about three weeks after that it move much faster.
These pictures were taken from the sixth floor and show that the roof above the six floor has been taken off and some of the fifth floor has been taken off.
5/23/24
In-progress concrete demo on the balcony side of the building
Completed dowels for the bottom mat of steel
Form board decking installed at the North end of the 2nd floor walkway
Form board decking installed at the North end of the 2nd floor walkway
5-17-24
In-progress demolition of the roof slab
In-progress concrete demo in front of Unit 205
Beam removal at the 1st floor walkway
Ledger board installed for the 2nd floor slab construction
